F-35 Joint Strike Fighter: More Actions Needed to Explain Cost Growth and Support Engine Modernization Decision

GAO-23-106047 Published: May 30, 2023. Publicly Released: May 30, 2023.
Jump To:

Fast Facts

The Department of Defense's most expensive weapon system—the F-35 aircraft—is now more than a decade behind schedule and $183 billion over original cost estimates.

This program is weighing options to upgrade its engine and cooling system. But it hasn't taken some important steps, such as fully assessing the costs and technical risks of the different options. DOD also doesn't plan to manage the upgrades as a separate acquisition program. This would limit Congress's insight into possible future cost increases.

We recommended ways to address these and other issues, including actions DOD should take and Congress should consider.

The F-35

An F-35 fighter jet is on asphalt. The sun is setting behind it.

Skip to Highlights

Highlights

What GAO Found

The F-35 program continues to experience schedule delays, cost growth, and late deliveries. Program delays in completing the F-35 simulator continue to prevent the Department of Defense (DOD) from completing the testing required to demonstrate that the F-35 is ready for full manufacturing rates, even though the program is already producing over 125 aircraft per year.

The F-35 program's total procurement costs have increased by $13.4 billion since the last cost estimate in 2019. This is, in part, due to DOD spreading out aircraft purchases and adding years to its delivery schedule. Contractors also continue to have challenges with delivering aircraft and engines on time, but they are working to address these issues.

Further, DOD is 5 years into a development effort to modernize the F-35's capabilities. This effort, known as Block 4, is experiencing developmental delays for important technology updates. Block 4 costs also grew to $16.5 billion, an increase of more than $1 billion since GAO last reported.

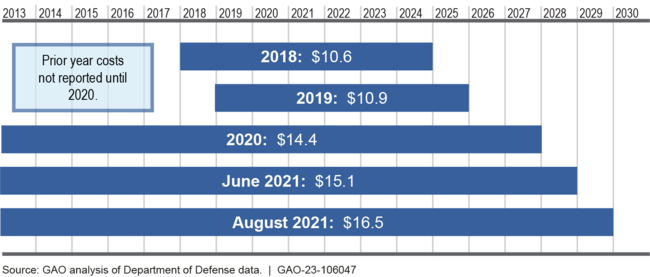

F-35 Block 4 Modernization Cost Increases since 2018 (then-year dollars in billions)

F-35 Block 4 Modernization Cost Increases since 2018 (then-year dollars in billions)

The program's cost reporting mechanisms do not fully explain the reasons for cost growth. For example, DOD's reports to Congress on Block 4 cost growth do not distinguish higher-than-expected costs for previously planned Block 4 capabilities from growth due to adding new capabilities. Consequently, Congress does not have a complete picture of escalating F-35 modernization costs.

The program is exploring options for modernizing the F-35's engine and thermal management system that is used to cool aircraft subsystems that generate heat. The program plans to manage this multi-billion dollar effort under the existing program, which is scheduled to transition to sustainment soon and that would limit congressional oversight. The cooling system is overtasked, requiring the engine to operate beyond its design parameters. The extra heat is increasing the wear on the engine, reducing its life, and adding $38 billion in maintenance costs.

The program assessed some engine and cooling improvement options, but it has not fully defined the requirements for how much future cooling the aircraft will need. By obtaining this key information, DOD and the services would be more informed about the future performance, cost, and technical implications.

Why GAO Did This Study

The F-35 Lightning II Joint Strike Fighter program is DOD's most expensive weapon system program. DOD estimates it will cost nearly $1.7 trillion to buy, operate, and sustain the aircraft and systems over its lifetime. DOD is also assessing options for modernizing its engine.

Congress included provisions in three statutes for GAO to review the F-35 program and a Senate report included another. This report (1) identifies the F-35's progress toward full-rate production, (2) assesses DOD's F-35 modernization effort (known as Block 4), and (3) assesses DOD's approach for modernizing its engine and thermal management system. GAO reviewed program, DOD, and contractor documentation on these topics and interviewed program, DOD, and contractor representatives. GAO assessed the program's progress against its own plans. GAO also applied its cost estimating and technology readiness leading practices, as appropriate.

Recommendations

Congress should consider directing the F-35 program to manage the engine modernization as a separate program. GAO added this matter for Congress because DOD has not committed to a separate engine program consistent with GAO's recommendation. GAO made seven total recommendations to DOD, including that it improve its reporting on Block 4 cost growth and define engine requirements. Overall, DOD concurred with three, partially concurred with three, and did not concur with one recommendation. GAO believes all the recommendations are warranted.

Matter for Congressional Consideration

Matter Status Comments
Congress should consider directing the Office of the Under Secretary of Defense for Acquisition and Sustainment to ensure the F-35 engine and thermal management modernization effort is managed as a separate program, with its own distinct cost, schedule, and performance baseline.
Closed – Implemented
Congress took action in Section 226 (c) of the FY24 NDAA stating that the Secretary of Defense shall designate all activities relating to the modernization, upgrade, and integration of the major subsystems of the F-35 propulsion and thermal management modernization effort collectively, as a single major subprogram of the F-35 aircraft acquisition program. This action meets the intent of our recommendation.

Recommendations for Executive Action

Agency Affected Recommendation Status
Department of Defense The Under Secretary of Defense for Acquisition and Sustainment should ensure the F-35 program office reports to Congress on cost differences between original estimates and actual costs for a defined group of modernization capabilities over time. (Recommendation 1)
Open
DOD concurred with this recommendation. As of June 2024, DOD was still determining actions it would take to address this recommendation.
Department of Defense The Under Secretary of Defense for Acquisition and Sustainment should ensure the F-35 program conducts a technology readiness assessment to evaluate TRLs for all critical technologies and systems for engine and thermal management modernization to inform the military services' modernization decisions. (Recommendation 2)
Open
DOD concurred with this recommendation. In December 2023, Congress included a provision in the fiscal year 2024 National Defense Authorization Act, which directed the Program Executive Officer for F-35 to complete a cost-benefit and technical risk analysis of the aircraft modernization efforts. As of June 2024, DOD was still determining actions it would take to address this recommendation.
Department of Defense The Under Secretary of Defense for Acquisition and Sustainment should ensure the F-35 program matures all critical technologies and systems for engine and thermal management modernization to a TRL 7 prior to starting product development. (Recommendation 3)
Open
DOD partially concurred with this recommendation. In December 2023, Congress included a provision in the fiscal year 2024 National Defense Authorization Act that directed the Program Executive Officer for F-35 to complete a cost-benefit and technical risk analysis that determines and evaluates F-35 modernization benchmarks. DOD's Technical Risk Assessment Methodology requires that each critical technology has achieved the necessary level of technology maturity. As of June 2024, DOD was still determining actions it would take to address this recommendation.
Department of Defense The Under Secretary of Defense for Acquisition and Sustainment should ensure the F-35 program reports the full life-cycle costs, for each engine and thermal management modernization option, including integration and any necessary related aircraft upgrade costs, to inform the military services' modernization decisions. (Recommendation 4)
Open
DOD concurred with this recommendation. In December 2023, Congress included a provision in the fiscal year 2024 National Defense Authorization Act, which directed the Program Executive Officer for F-35 to complete a comprehensive cost-benefit analysis of the F-35 modernization efforts. As of June 2024, DOD was still determining actions it would take to address this recommendation.
Department of Defense The Under Secretary of Defense for Acquisition and Sustainment should ensure the F-35 program obtains an independent cost estimate for all engine and thermal management modernization options, including integration and any necessary related aircraft upgrade costs, to inform the military services' modernization decisions. (Recommendation 5)
Open
DOD partially concurred with this recommendation. In December 2023, Congress included a provision in the fiscal year 2024 National Defense Authorization Act that directed the F-35 Program Executive Officer to obtain an independent cost estimate as part of their overall engine modernization cost-benefit analysis. As of June 2024, DOD was still determining actions it would take to fully address this recommendation.
Department of Defense The Under Secretary of Defense for Acquisition and Sustainment should direct the F-35 program office to reevaluate its comparative analysis after the military services define their power and cooling requirements, and before proceeding with development of the engine and thermal management modernization effort. (Recommendation 6)
Open
DOD did not concur with this recommendation. In December 2023, Congress included a provision in the fiscal year 2024 National Defense Authorization Act, that directed the Secretary of the Air Force and the Secretary of the Navy to establish requirements for the propulsion, power and cooling, thermal management, and electrical power systems of the F-35 aircraft. In the same section, Congress included a provision that directed the Program Executive Officer for F-35 to conduct cost-benefit and technical risk analysis that evaluates the F-35 modernization efforts based on the services' requirements. As of June 2024, DOD was still determining actions it would take to address this recommendation.
Department of Defense The Under Secretary of Defense for Acquisition and Sustainment should manage F-35 engine and thermal management modernization as a separate program, with its own distinct cost, schedule, and performance baseline. (Recommendation 7)
Closed – Implemented
DOD partially concurred with this recommendation. On March 12, 2024, the Under Secretary of Defense for Acquisition and Sustainment directed the F-35 program to designate Engine and Power Thermal Management Modernization development as a major subprogram of the overall F-35 acquisition program. Designating engine and power management modernization efforts as a major subprogram meets the intent of our recommendation by establishing a distinct cost, schedule, and performance baseline.
